Building a Gravel Driveway on Blackland Clay in Kaufman County

Kaufman County sits in the heart of Texas' Blackland Prairie. The soil here behaves differently from sandy or loamy soils, and driveways built without accounting for that movement will fail. Here is what the clay actually does, and what that means for your driveway.

What Is Blackland Prairie Soil and Why Does It Matter for Driveways?

Kaufman County lies within Texas' Blackland Prairie, a geologic region characterized by expansive black clay soils derived from chalk and marl. The dominant soil series in this part of the county is the Houston Black clay, with secondary occurrence of the Ferris clay in lower-lying areas. Both are classified as Vertisols, which means they are soils that move vertically.

Vertisols are dominated by smectite clay minerals, specifically montmorillonite, which absorb water molecules between clay platelets. When the clay absorbs water, it physically expands, pushing the surface upward. When the soil dries, the platelets release water, the clay contracts, and the surface subsides. This shrink-swell cycle creates the characteristic vertical cracks you see in dry Blackland clay, sometimes an inch or more wide and several feet deep.

For driveways, this matters because any material placed on top of active clay will move with the soil beneath it. Gravel that compacts well on stable sandy subgrade becomes unstable on actively cycling clay. The fix is not about the gravel, it is about isolating the surface material from the subgrade movement. That is what a properly installed base layer does.

What Happens Without a Base Layer

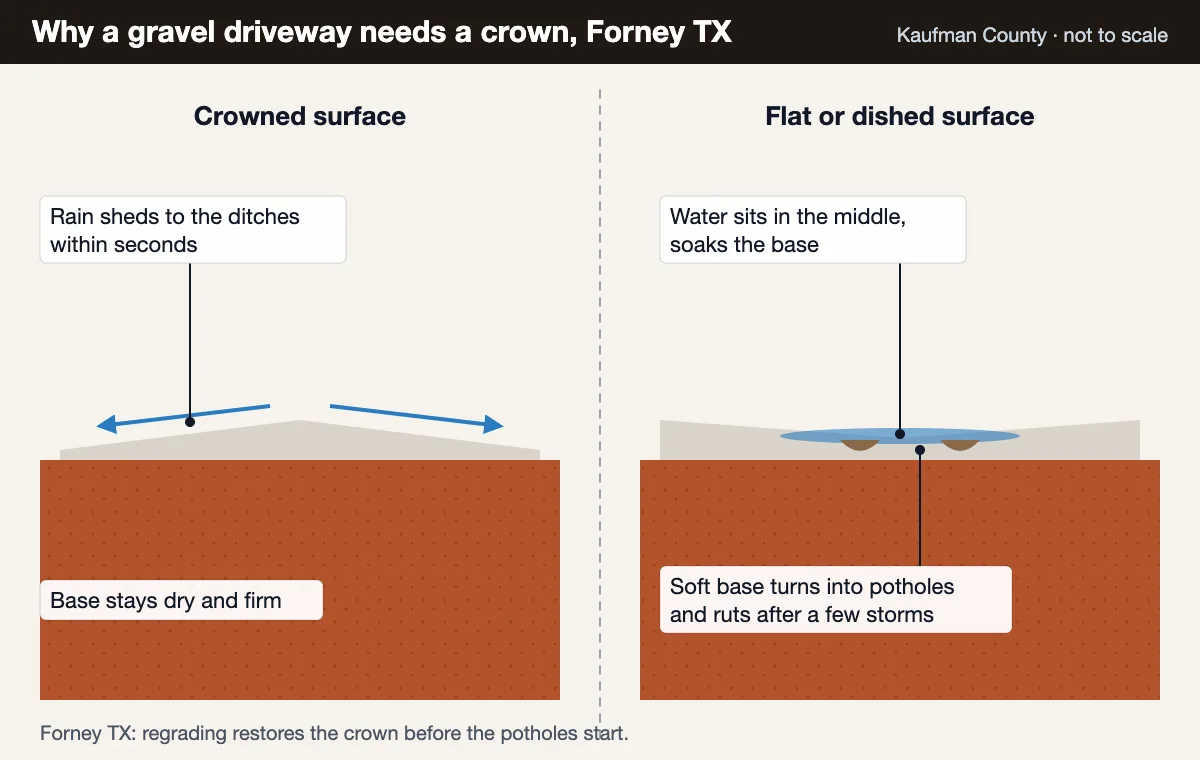

Gravel driveway on Kaufman County Blackland clay without a crown or base: water ponds and the surface ruts
What gravel laid straight on the clay turns into: water collects, the clay underneath softens, and the gravel is pushed down into it as ruts and potholes.

Gravel placed directly on Blackland clay without a base layer will initially look fine. After the first wet season, you will see the first signs of failure: the gravel begins to push into the clay surface, creating ruts that hold water rather than shedding it. Water pooling in ruts accelerates the saturation of the clay directly below, which accelerates expansion in those spots. Vehicle weight on saturated clay without base material pumps the clay up around the tire contact zones, gradually displacing gravel to the driveway edges.

Within two to three wet seasons, a gravel driveway installed without base on active Blackland clay typically exhibits: deep center ruts, bare clay exposed in high-traffic zones, gravel berm buildup on the edges, and crown reversal where the center of the driveway is lower than the edges. At this point, a top-dress alone does not fix the problem, because the subgrade is now disturbed and the same failure will repeat.

The Base Layer: What, How Much, and Why

Blackland clay driveway Kaufman County TX: separation fabric and 4 to 6 in compacted base under the gravel surface
The fix in section: fabric to keep the base out of the clay, 4 to 6 in of compacted caliche or road base, then the surface course, crowned.

The standard base for gravel driveways on Blackland clay in Kaufman County is 4 to 6 inches of compacted caliche or road base material. Caliche is a naturally occurring calcium carbonate soil found in geological deposits in this region. It compacts into a semi-rigid layer that does not expand or contract with moisture changes, which is exactly the property you need against an active clay subgrade.

The base layer works by distributing vehicle load over a larger area of the subgrade, reducing the point-load pressure that causes clay pumping under tires. It also creates a capillary break that slows moisture movement from the clay into the gravel above. The net effect is a surface that holds its position through the wet-dry cycle rather than moving with the soil underneath.

On particularly active clay subgrade, lime stabilization is an additional option before the caliche base is installed. Agricultural lime mixed into the top few inches of native clay chemically modifies the soil's shrink-swell potential. This is more common on construction sites than residential driveways, but it is worth knowing about for severely problematic sites.

Material Selection for Kaufman County Driveways

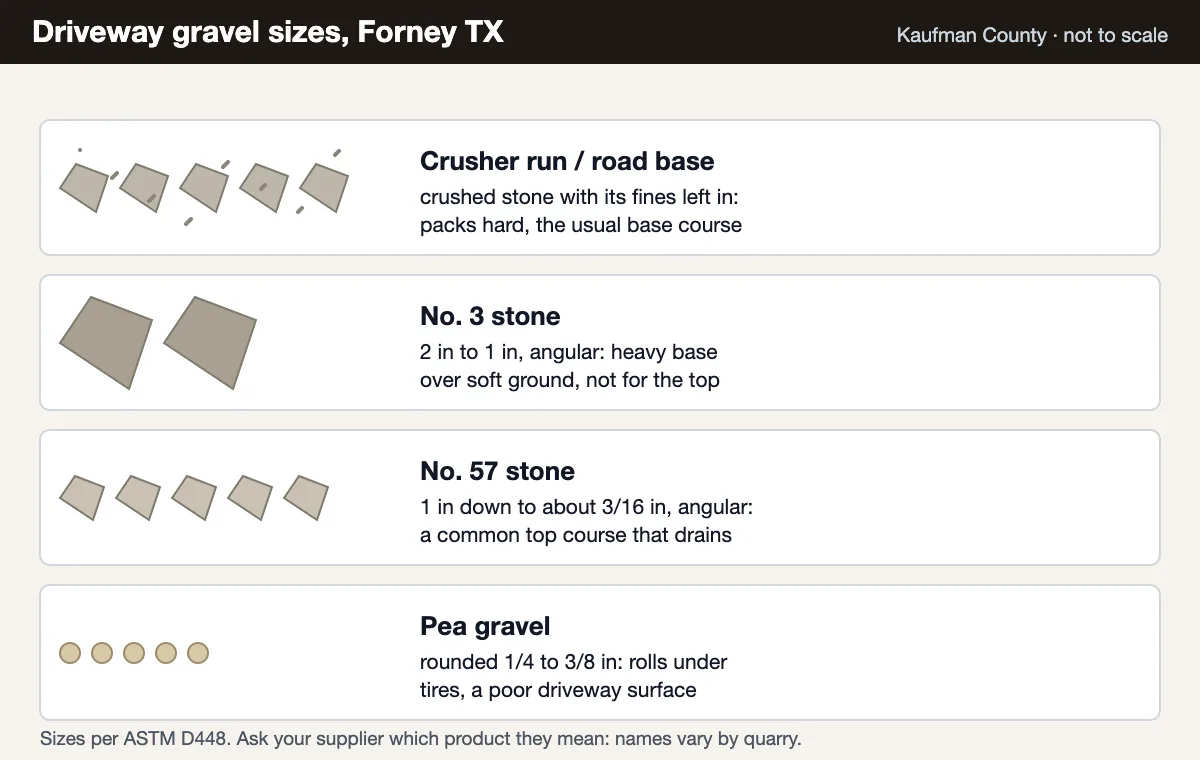

Driveway gravel sizes for Kaufman County Blackland clay: crusher run, No. 3, No. 57 and pea gravel
The usual materials by size. On Blackland clay, angular stone with fines that pack (road base, caliche) does the structural work; rounded pea gravel does not belong on a driveway.
MaterialBest UseClay Performance
Crushed limestone #57Finish layer, residential drivewaysExcellent: angular, locks under compaction
Crushed limestone #89Finish layer, pedestrian areasGood: finer, surface stays smooth
CalicheBase layer, low-traffic surface roadsExcellent base material, dusty in dry months
Road base (flex base)Base layer, heavy equipment areasExcellent: densely graded, high load capacity
Pea gravel (rounded)Drainage, landscaping onlyPoor: migrates sideways on clay, no locking
Crushed concreteBudget base or surfaceGood: economical, similar performance to limestone

Drainage: The Other Half of the Equation

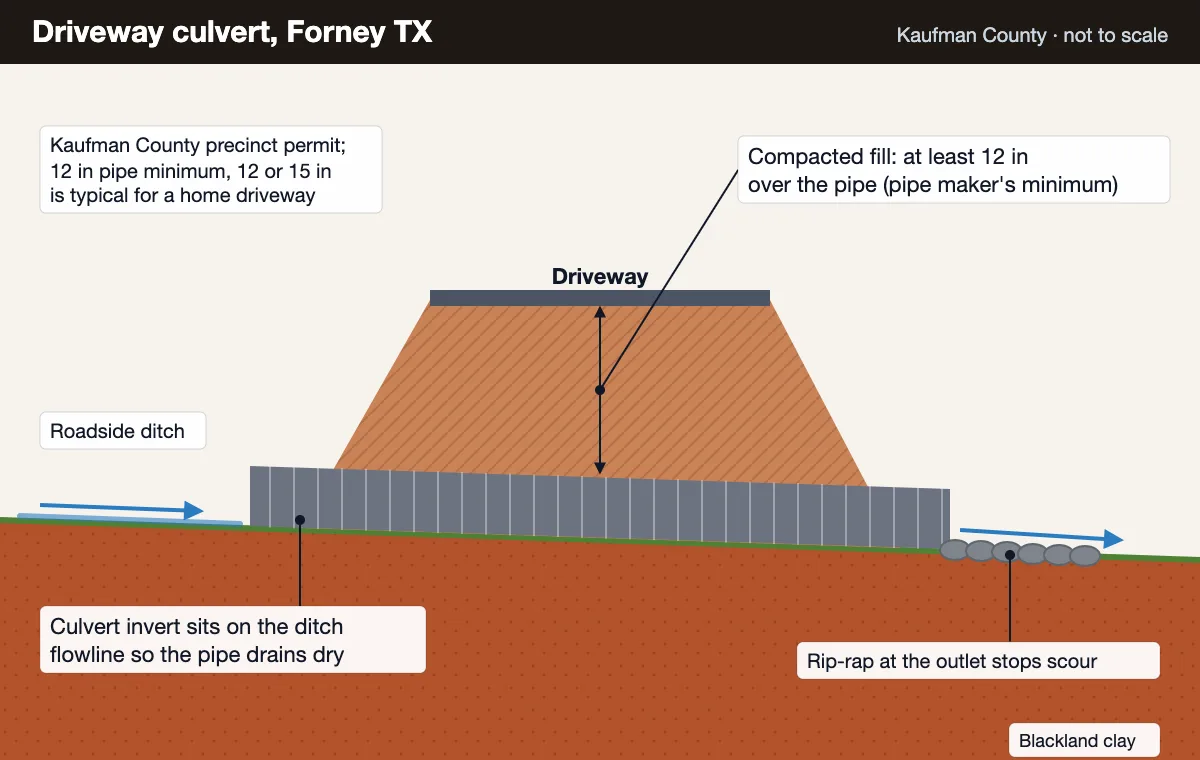

Driveway culvert drainage on Kaufman County clay: pipe on the ditch flowline so water keeps moving
Drainage at the road: a culvert set on the ditch flowline keeps water moving past the driveway instead of soaking the base from the side.

Blackland clay drains slowly. The clay particles are small and pack densely, which limits downward water movement through the soil. This means water sits on or near the surface of the clay much longer than it would on sandy soil. A driveway on Blackland clay that does not have good surface drainage will have standing water on and around the gravel for days after a significant rain, keeping the clay subgrade saturated longer and prolonging the period when the soil is most susceptible to load damage.

The drainage solution for a gravel driveway is crown and side channels. Crown refers to the cross-slope of the driveway surface, which should be 2 to 4 percent higher in the center than at the edges. This sheds water to the sides rather than letting it pool. Side channels or drainage swales direct shed water away from the driveway corridor so it does not saturate the shoulder area and undermine the edge of the base layer.

On longer driveways, cross drainage may also be needed: shallow dips or culverts that let water crossing the driveway path pass through rather than running parallel to the driveway and concentrating where it should not.

Seasonal Maintenance on Blackland Clay

Even a properly installed driveway on Blackland clay benefits from annual maintenance. The clay movement is gradual but cumulative, and the crown that was perfect at installation will flatten over years of vehicle traffic. Scheduling a grading pass in late spring, after the heavy rain season but before the summer dry-out, restores the crown and addresses any ruts that formed during wet months. Adding fresh material every 3 to 5 years replaces what has been compressed into the base and migrated to the shoulders.

Get a Site-Specific Assessment

Blackland clay varies across Kaufman County. Soil in river bottom areas behaves differently than upland clay, and some areas have a shallower clay cap with firmer material below. An on-site assessment lets us tell you exactly what your specific location needs. Forney Gravel Co. offers free estimates throughout Kaufman County.

Request a Free Estimate

Frequently Asked Questions

What is Blackland clay and why does it affect driveways in Kaufman County?
Blackland clay is an expansive clay soil that swells when wet and shrinks when dry. Kaufman County sits in the Texas Blackland Prairie, where this soil dominates. Driveways built directly on Blackland clay without a stabilizing base layer will rut, shift, and shed material as the clay cycles through wet and dry seasons each year.
How deep should a caliche base be on Blackland clay?
4 to 6 inches of compacted caliche is the standard base depth for residential driveways in Kaufman County. Particularly active or wet clay sites may benefit from a deeper base. The caliche distributes vehicle load and reduces the point-load pressure that causes clay pumping.
What gravel works best on Blackland clay in Kaufman County?
Crushed limestone #57 is the most reliable finish material. Its angular edges compact and interlock, resisting displacement on unstable clay subgrade better than rounded materials like pea gravel. Caliche is a cost-effective choice for lower-traffic surfaces and is widely used as both base and finish on rural properties.
